Did you know that securing a FedRAMP ATO just became more optimized? FedRAMP discontinued the JAB Authorization option in August 2024, which transformed how cloud service providers approach federal compliance.
The change moves FedRAMP toward one designation of “FedRAMP Authorized” instead of different authorization tiers. Cloud organizations previously had to choose between JAB and Agency paths. JAB selected only about 12 cloud products each year through the FedRAMP Connect process. On top of that, agency sponsorship accounts for 70 percent of all FedRAMP ATOs, making it the primary route for most cloud services.
Let’s get into the fedramp ato process and compare the traditional fedramp jab approach with agency authorization. We’ll analyze which path helps cloud service providers save more time when seeking ato fedramp certification. The fedramp jab vs agency decision remains important despite recent changes, as a CSP must keep at least one ATO active with the FedRAMP PMO to maintain its Authorized designation.

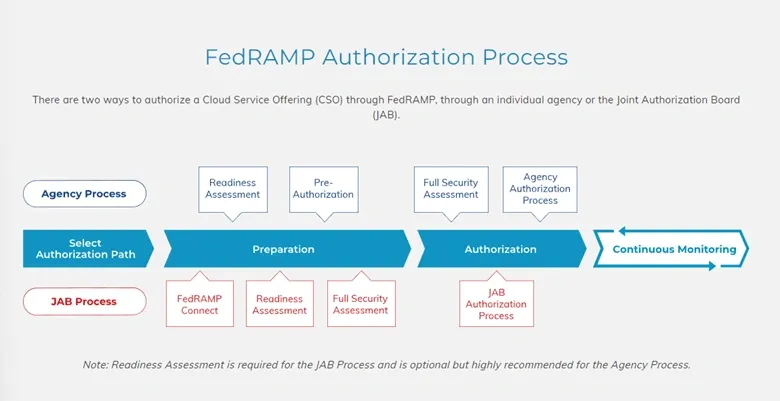

Understanding the FedRAMP ATO Process

Image Source: Box Blog
The FedRAMP Authority to Operate (ATO) is the life-blood of federal cloud security compliance. ATOs differ from other certifications by providing formal approval that lets cloud service providers (CSPs) operate within federal networks after meeting strict security requirements.
What is an Authority to Operate (ATO) in FedRAMP?
FedRAMP’s ATO provides official validation that a cloud service has passed detailed security assessments. The service must be secure enough to handle sensitive government data. CSPs need to monitor and update their services to stay compliant with FedRAMP security standards. Each federal agency customer must issue their own ATO for using the service, even after a cloud service becomes FedRAMP Authorized.
Role of 3PAOs in the FedRAMP ATO process
Third Party Assessment Organizations (3PAOs) serve as independent validators in the FedRAMP ecosystem. These organizations verify that CSPs meet government regulations and security frameworks through detailed security assessments. The authorization process requires 3PAOs to perform several vital functions:
- They assess a CSP’s security documentation
- They analyze gaps between current practices and FedRAMP requirements
- They test security through vulnerability scans and penetration testing
The 3PAO then creates a Security Assessment Report (SAR) with results and authorization recommendations. This independent verification builds trust among federal agencies that are thinking about new cloud solutions.
FedRAMP Ready vs In Process vs Authorized
Cloud service offerings fall into three distinct FedRAMP categories:
FedRAMP Ready shows that a 3PAO has verified a CSO’s security capabilities through a Readiness Assessment Report (RAR). The FedRAMP PMO reviews and accepts this report. This status, available at Moderate and High impact levels, indicates better chances of completing the authorization process.
FedRAMP In Process indicates that the CSP works toward authorization with a federal sponsor. Providers must show they have an operational system, committed leadership, and proper security categorization to earn this status.
FedRAMP Authorized marks the successful completion of the entire authorization process. Government agencies can reuse the security assessment, which reduces duplicate work significantly.
The FedRAMP PMO recognizes only these three official designations. Terms like “FedRAMP Compliant” or “FedRAMP Equivalent” have no official standing.
FedRAMP JAB Authorization: Timeline and Process

Image Source: AuditBoard
The Joint Authorization Board (JAB) path stands out as one of the toughest routes to get a FedRAMP ATO. This selective process only approves about twelve cloud products each year. These approvals target services that appeal to a wide government audience.
FedRAMP Connect and JAB Prioritization Criteria
Cloud Service Providers (CSPs) must go through the FedRAMP Connect process to get JAB authorization. They need to present a complete business case that meets three main criteria:
CSPs must first show demand equal to six customers. They need to fill out a Proof of Demand Worksheet that lists current federal customers, indirect customers, and formal agency requests. Current federal customer demand carries greater weight than potential customers.
Selected offerings must reach FedRAMP Ready status within 60 days or risk losing priority. The JAB also favors solutions that are built specifically for federal government needs.
Readiness Assessment Report (RAR) Requirements
The JAB path differs from agency authorization because it needs a formal Readiness Assessment Report (RAR) from a 3PAO. This report assesses the CSP’s ability to meet federal security requirements. The RAR must include a complete system overview, boundary documentation, data flow diagrams, and proof that it meets baseline requirements.
Security Package Components: SSP, SAP, SAR, POA&M
After completing the RAR successfully, CSPs need to prepare:
- System Security Plan (SSP): Documents the system’s security controls
- Security Assessment Plan (SAP): Outlines testing procedures and methodologies
- Security Assessment Report (SAR): Documents assessment results and risks
- Plan of Action and Milestones (POA&M): Tracks remediation plans for identified vulnerabilities
Monthly Continuous Monitoring Deliverables
CSPs must submit continuous monitoring reports every month with vulnerability scans, POA&M updates, and configuration management documentation. They also need to complete three months of continuous monitoring with the JAB before getting their provisional ATO.
Average Time to P-ATO via JAB Path
JAB authorization typically takes 8 to 24+ months based on how complex and ready an organization is. CSPs must finish the RAR, complete assessment, and three months of continuous monitoring after selection to receive a provisional ATO.
Agency Authorization Path: Flexibility and Speed
Cloud service providers can take a more flexible path to getting a FedRAMP ATO through agency authorization. This approach lets providers work directly with federal agencies that plan to use their cloud service, unlike the JAB route.
Sponsorship Requirements and Agency Kickoff
The first step is finding a government entity interested in your cloud service. A formal partnership starts after submitting an In Process Request (IPR) letter and work breakdown structure (WBS) to FedRAMP. The agency needs to confirm they will authorize the service within 12 months.
CSPs must meet at least one of these requirements to get “In Process” status on the FedRAMP Marketplace:
- Complete a formal kickoff meeting with all stakeholders
- Provide proof of contract award for the cloud service
- Show current agency use of the service
- Get FedRAMP Ready status
The kickoff meetings run 60-90 minutes and help everyone understand the system’s architecture, security features, and authorization timeline.
Optional Readiness Assessment for Agency ATO
The FedRAMP Readiness Assessment isn’t required for agency authorizations, unlike the JAB path. All the same, the FedRAMP PMO strongly suggests taking this step. Getting FedRAMP Ready status shows agencies that the CSP meets technical FedRAMP requirements.
Agency-Specific Risk Tolerance and Control Adjustments
Each agency can adjust security requirements based on their risk tolerance. This is a key benefit – agencies can approve cloud services that don’t perfectly match control implementations if they line up with specific organizational needs. On top of that, agencies might add requirements beyond the FedRAMP baseline if their risk posture demands it.
Security Assessment and Authorization Package Review
The authorization package review usually takes 3-4 weeks. It needs a full evaluation of the System Security Plan (SSP), Security Assessment Plan (SAP), Security Assessment Report (SAR), and Plan of Action and Milestones (POA&M). The agency looks at major security concerns during this time, such as FIPS 140-2 compliance and multi-factor authentication setup.
Timeframe Variability Based on Agency Involvement
The whole agency authorization process typically runs 4-5 months, which is substantially faster than the JAB’s 8-24+ month timeline. The process breaks down into partnership setup (2 weeks), authorization planning (4 weeks), kickoff (1 week), quality review (3-4 weeks), fixes (3 weeks), and final review (4 weeks).
The agency’s response time directly shapes how fast things move. Regular check-ins and clear communication between the CSP, 3PAO, and agency help speed up the authorization process and avoid delays.
JAB vs Agency: Which Path Saves More Time?
Time-to-market needs often determine the choice between JAB and agency authorization pathways. Each option comes with its own timeline that can affect your federal cloud strategy by a lot.
JAB Selection Bottlenecks and Limited Slots
The JAB selection process creates a major bottleneck. It accepts only 12 cloud products each year through FedRAMP Connect. Your business might wait years to be considered because getting selected isn’t guaranteed. The agency authorization doesn’t need this competitive selection process. CSPs can take the initiative to find and work with interested federal agencies.
Agency-Driven Timelines and Resource Availability
The time difference between these paths stands out. JAB authorization usually takes 7-9 months. Agency ATOs need just 4-6 months. CSP-supplied packages might wrap up in 2-3 months. The agency’s priority level for your authorization drives these timelines. Even with a faster process on paper, delays can happen if you’re not high on their list.
What Readiness Assessment Means for Time and Cost
The Readiness Assessment Report (RAR) must be part of JAB. It costs about $50,000 and takes two months. Agency authorization lets you skip this step, saving time right away. But a RAR helps spot security gaps early and shows federal customers you’re ready for business.
Continuous Monitoring Ownership Differences
JAB authorization needs monthly continuous monitoring reports throughout the process. Agency authorization has similar requirements but offers more flexibility based on the sponsoring agency’s rules.
Case Scenarios: When Each Path is Faster
JAB authorization works best for CSPs that want to reach many agencies at once and can handle longer timelines for better market visibility. Book a Readiness Call to see which path lines up with your needs. Agency authorization fits better when you already have an agency sponsor and need to move quickly. Complex environments usually take two years to get FedRAMP authorized.
Conclusion
FedRAMP ATO paths give you distinct advantages based on your organization’s goals and timeframes. In this piece, we’ve seen that agency authorization saves time substantially compared to the JAB route—4-6 months versus 7-9 months on average. On top of that, the agency path gives you more flexibility with security requirements tailored to specific agency risk tolerance.
The JAB Authorization option’s recent discontinuation in August 2024 has altered the map for cloud service providers. This move toward a single “FedRAMP Authorized” designation shows how important it is to really understand the authorization process, whatever path you choose.
Several factors contribute to time savings between paths. Agency authorization lets you skip the competitive JAB selection process with its limited 12 slots per year. CSPs can work directly with interested federal agencies and complete a CSP-supplied package in just 2-3 months. Organizations with existing agency relationships benefit from this direct route.
The paths have nowhere near the same monitoring requirements. JAB authorization needs strict monthly deliverables throughout the process. Agency authorization often works with more flexible protocols based on the sponsoring agency’s priorities.
The best path ended up depending on your specific business goals and federal market strategy. Cloud services targeting multiple agencies at once might still benefit from JAB’s broader marketplace visibility despite longer timelines. Companies that want faster market entry with a specific agency customer should take the agency path. Not sure which option makes more sense for your organization? Book a Readiness Call with our experts to assess your situation and develop a strategic approach to FedRAMP authorization.
The federal compliance experience needs careful navigation. With proper planning and understanding of these two paths, your organization can achieve FedRAMP authorization efficiently while maintaining the resilient security standards needed for federal cloud services.
Key Takeaways
Understanding the time differences between FedRAMP authorization paths is crucial for cloud service providers planning their federal compliance strategy.
• Agency authorization saves 3-5 months compared to JAB path (4-6 months vs 7-9 months average timeline)
• JAB path faces major bottlenecks with only 12 cloud products selected annually through competitive FedRAMP Connect process
• Agency path offers flexibility allowing tailored security requirements based on specific agency risk tolerance and needs
• Readiness Assessment Report costs $50,000 and adds 2 months but is mandatory for JAB, optional for agency authorization
• JAB authorization discontinued in August 2024, making agency sponsorship the primary route for new FedRAMP authorizations
• CSP-supplied packages can complete in 2-3 months when working directly with interested federal agencies
The agency authorization path consistently delivers faster time-to-market while maintaining the same rigorous security standards required for federal cloud services. With JAB authorization no longer available for new applications, understanding agency sponsorship requirements and building relationships with potential federal customers becomes even more critical for successful FedRAMP compliance.
FAQs
Q1. What is the main difference between JAB and Agency authorization paths in FedRAMP? The primary difference is in the timeline and process. Agency authorization typically takes 4-6 months and offers more flexibility, while JAB authorization used to take 7-9 months and had a more rigorous selection process. However, as of August 2024, JAB authorization has been discontinued for new applications.
Q2. How long does it typically take to obtain a FedRAMP ATO? The timeline varies depending on the path chosen and the complexity of the system. Agency authorization generally takes 4-6 months, while a CSP-supplied package might be completed in 2-3 months. More complex environments may require up to two years for full authorization.
Q3. Is a Readiness Assessment Report (RAR) mandatory for FedRAMP authorization? A RAR is optional for agency authorization but was mandatory for the JAB path. While skipping this step can save time initially, completing a RAR helps identify security gaps early and demonstrates readiness to potential federal customers.
Q4. What are the key components of a FedRAMP security package? The main components of a FedRAMP security package include the System Security Plan (SSP), Security Assessment Plan (SAP), Security Assessment Report (SAR), and Plan of Action and Milestones (POA&M). These documents collectively demonstrate the cloud service’s security posture and compliance with FedRAMP requirements.
Q5. How does continuous monitoring differ between authorization paths? Under JAB authorization, monthly continuous monitoring deliverables were required throughout the process. With agency authorization, continuous monitoring requirements exist but are often more flexible based on the sponsoring agency’s protocols. This flexibility can potentially save time and resources for cloud service providers.
